SOE15115 – Beech Walk, Epsom (Conaways Close / Curvan Close)

PROJECT: SOE15115

Location: Beech Walk, Epsom

(Conaways Close / Curvan Close)

Update: 29.04.2026

Project complete.

Update: 17.03.2026

The team is currently working in Ewell House Grove and anticipates completing all engineering works by next Tuesday. Reinstatement works will follow immediately after, and once everything is finished, the site will be fully cleared.

Following this, the team will move on to Hazel Mead and Persfield Close. Each of these locations is expected to take approximately two weeks to complete.

Notifications will be sent to all residents ahead of the works in these areas.

Thank you for your cooperation and understanding.

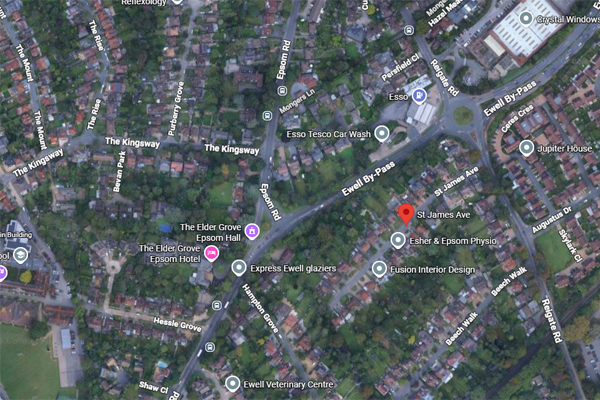

WCB Utilities Ltd Project Beech Walk, Epsom (St James Avenue)

Update: 10.02.2026

Works at Conaways Close commenced on Monday 9th. The engineering works at this location are expected to take approximately one week to complete.

Following this, we will move on to Curvan Close, where the works are estimated to take approximately two to three weeks to complete.

Update: 27.01.2026

Works have commenced on Chuters Grove, where an additional gas main has been identified at the rear of the close following investigation. Further investigations are required to determine the function of this main, after which the replacement of the existing gas main will begin.

Upon completion, works will proceed to Conaways Close. Although the programmed start date is 02/02/2026, it is anticipated that works will commence later this week.

Update: 14.01.2026

Works on Hessle Grove have been slightly delayed, which has had a knock-on effect on the start of works in Shaw Close. Works in Shaw Close will now commence on 19th January.

Once works in Shaw Close are completed, the team will move on to Chuters Grove.

Update: 17.12.2025

Works on Hessle Grove are approximately 50% complete, and the site will be closed for the Christmas period. Works are scheduled to recommence in the new year during the week commencing 5 January 2026, at which point the remaining works on Hessle Grove will be completed. In addition, works are programmed to commence on Shaw Close during the week commencing 12 January 2026.

Update: 02.12.2025

Works are currently underway on Windmill Avenue. We are experiencing some issues with parked vehicles, which we hope will not cause delays to the programme. Engineering works are expected to continue up to the week commencing 15th December, when we plan to start works on Hessle Grove before the Christmas shutdown.
We will then return to site after the Christmas break to continue the programme.

Update: 19.11.2025

We are currently undertaking works on Purberry Grove, which are expected to continue through to the week commencing 1st December. Upon completion, we will commence works on Windmill Avenue, which will be carried out under give-and-take traffic management.

Update: 05.11.2025

Please be advised that works have commenced on St James Avenue and are progressing well. Upon completion of works on this road, the team will move into Purberry Grove to continue the next phase of the project.
